Dan Demole
Plan sheet · rev 6 · 8 ft × 4 ft · PT frame, cedar skin, steel roof

Roxbury Firewood Shed

Pressure-treated frame and floor, vertical cedar slats on three sides, open front, black ribbed-steel roof with cedar fascia and 11–12" overhangs. Frame stained black, cedar left natural. No tarp, no pallet, no digging. Everything from Home Depot or Lowe's in stock lengths.

8' × 4'
footprint (floor frame)
10' × 5'10"
roof, 12" side / 11" front & rear overhang
6'6" / 5'6"
front / rear height, 3:12 pitch
~1 cord
stacked 4' high
~$880 + $420
phase 1 + phase 2 materials, late-2026 big-box est.
Renderings

Construction stages and finished appearance

Illustrative visualization. Roof pitch is 3:12 across the 48-inch post spacing, producing a 12-inch drop. Roof overhangs continue the same pitch; confirm actual cut lengths and load capacity before construction.

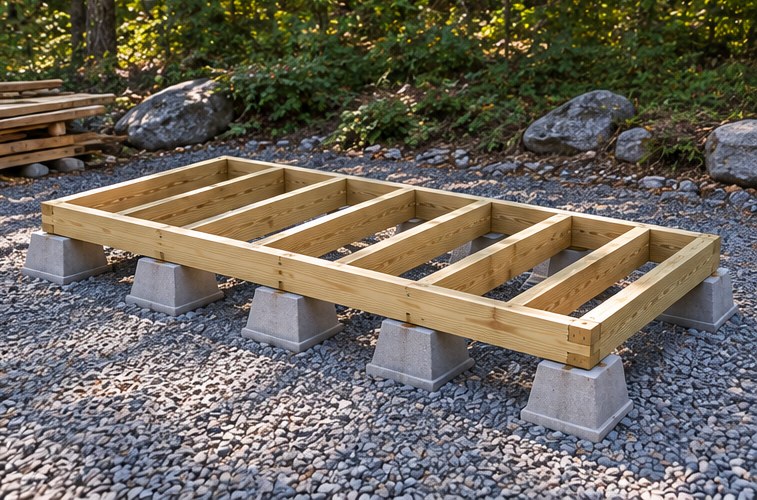

Stage 1: 2×6 floor frame on deck blocks
1 · Floor frame on blocks

Stage 2: black-stained PT frame, floor slats, beams, rafters and purlins
2 · PT frame, floor, roof framing

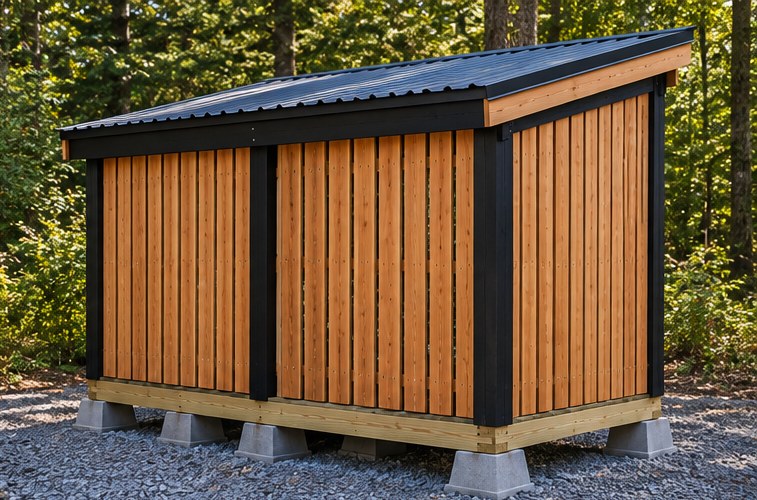

Stage 3: cedar slats on back and sides, steel roof and cedar fascia
3 · Cedar skin, steel roof, fascia

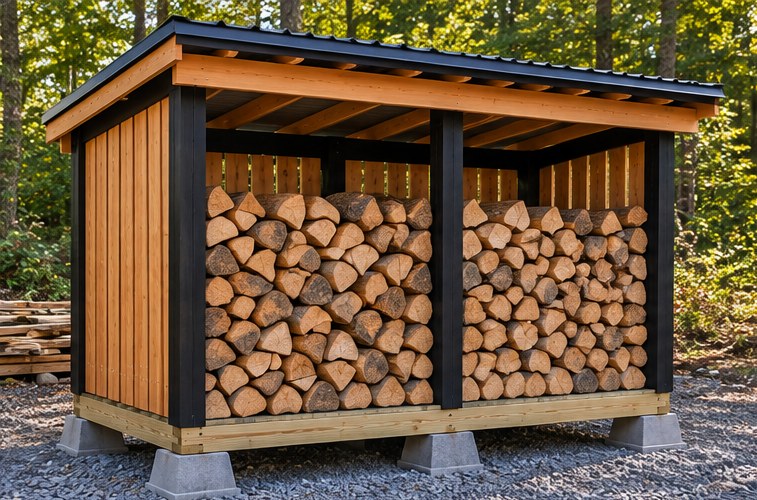

Finished shed, open front stacked with firewood
4 · Finished, open front

Concept renderings. Use the dimensioned plans below for layout; the renderings show six blocks and posts bearing on the deck, the plan uses nine blocks with posts in the block sockets.

Build day

Build run sheet

Updated after the Home Depot trip on Oct 18. Everything for the structure is on hand; the roof and the cedar are still to buy, so the build stops cleanly before the fascia.

On handAll PT lumber, 9 deck blocks, paver base, TimberLOK 4", H2.5A ties, 2 × SD9 1½" (SD9112R100), Deckmate #9×3", Paslode 30° 3" HDG ring-shank, black stain, Senco 15 ga 2½" (fascia)
Still to buy4 steel panels + roofing screws + closure strips · 1×6 cedar fascia (2 × 10', 2 × 8') · Phase 2: cedar decking + 15 ga DA 2" stainless nails

Correction before you cut: block layout and center joist

The deck blocks have a 4×4 socket, so each post drops into a block and the rim or end joist bears on the block's ledge beside it. That means the six post blocks are centered on the posts, not on the frame edges. The middle joist also moves 2" off center so it sits beside the mid posts instead of where they stand.

Block rowDistance from front edge of frameBlock centers, from left end of frameWhat it carries
Front (posts)3¼"3¼" · 48" · 92¾"Front posts in socket; front rim and end joists on ledge
Middle24"¾" · 50½" · 95¼"End joists and center joist at mid-span
Rear (posts)44¾"3¼" · 48" · 92¾"Rear posts in socket; rear rim and end joists on ledge

Frame is 96" × 48" outside. Diagonals must match at 107 5⁄16". Joists at 16, 32, 64 and 80" on center; the center joist's left face at 49¾" (right against the mid posts) instead of at 48".

Today · Sunday afternoon (≈3½ hrs of daylight; sunset ≈ 6:05 pm)

  1. Sort and cut (30 min). Stack 2×6s, 4×4s, 2×4s separately, off the ground. Cut seven 45" joists from four 2×6×8s. Leave the posts uncut until the frame is set.
  2. Lay out (20 min). Stakes and string for a 96" × 48" rectangle, open side facing south/southwest. Check diagonals at 107 5⁄16". Mark the nine block centers from the table above with spray paint or nails.
  3. Pads and blocks (1½ hrs). At each mark, scalp a 14" square about 2" down, fill with paver base, tamp hard (end of a 4×4 offcut works), set the block with the socket square to the frame. Level all nine to each other with a straight 2×4 and a 4' level. This is the step that matters most.
  4. Floor frame (1 hr). Screw the two 96" rims to the two 45" end joists with Deckmate 3", three per corner. Set it on the blocks, check diagonals, then fit the five interior joists (end-screw 3 Deckmate per end). Shim any gap between frame and block with composite shims.
  5. Stop point. Frame square, level, sitting on all nine blocks. Cover the lumber pile. Nothing is standing that can fall over.
  6. If daylight remains: cut posts (three at 78", three at 66") and chamfer the tops on the table saw. Do not stand them tonight without braces.

Next session · full day, ideally with a helper

  1. Posts. Drop each into its block socket in the inside corner of the frame. Plumb both ways, brace to stakes with the 1×4s and offcuts. Corner posts: 2 TimberLOK through the rim and 2 through the end joist. Mid posts: 2 TimberLOK through the rim, 2 Deckmate from the center joist into the post.
  2. Floor slats. Ten 2×4s flat across the joists, 1½" spacer, notched around posts. Paslode 3" HDG with the framing nailer, two per joist.
  3. Beams. Clamp each 2×6×10 to the outer faces of its three posts, top flush, 12" past each end. Two TimberLOK per post.
  4. Nailers. 44¼" 2×4s flat between posts at 20" and 40" above the rim. Deckmate 3", two per end.
  5. Rafters and ties. Six 72" rafters at 24" o.c., 11" overhang front and rear. One H2.5A per rafter at each beam, fastened with SD9 screws only.
  6. Purlins, braces, diagonals. Four 2×4×10 purlins flat at 2, 24, 48 and 70" from the low edge. Two 24" knee braces at the front corners. Two 1×4 diagonals across the back posts. Remove the post stakes.
  7. Stop point. Fully framed and braced. It can stand unroofed until the panels arrive; load wood under a tarp on the purlins if needed.

After buying the roof and cedar fascia

  1. Fascia. Sides first (72", 14° ends), then front and rear lapping over. Senco 15 ga 2½" from the shelf at home, plus two Deckmate at each corner.
  2. Roof. Closure strips, then panels from the downwind end, one-rib overlap, roofing screws into every purlin.
  3. Stain once the PT passes the water-bead test. Phase 2 cedar walls whenever suits.
Weatherproofing

How it stays dry without a tarp

The roof overhangs 11–12" on every side, so rain on the pile is only wind-driven. The floor is 2×4 slats on 2×6 joists sitting 7" off the ground on deck blocks, so nothing wicks from below and air moves under the pile. Back and sides are 2⅝" cedar slats with 1" gaps: they stop most driven rain and let the pile breathe. Face the open front south or southwest; put the back toward prevailing wind-driven rain (northwest in most of CT).

Appearance

Why it won't read as an outbuilding

Five decisions, all designed in rather than bolted on: black semi-transparent stain on every piece of PT so no green shows; vertical cedar slats at an even 1" gap, run from the ground to the roof so the rim and blocks are hidden; a ribbed steel roof in black instead of a plastic lid; 1×6 cedar fascia on all four roof edges so you see wood, not rafter ends; black hex-head TimberLOK screws at the visible post joints, and every other fastener hidden or countersunk. The pile itself is the facade, so stack split faces out, ends flush.

References

Reference looks

The finished look this plan is built to: vertical cedar slats on a black-stained frame, black steel roof with cedar fascia, stacked wood as the visual.

Front three-quarter view of the finished shed Rear three-quarter view of the finished shed
Drawings

Drawings

Scale: 1 inch = 3 units. All dimensions in inches. Lumber is drawn at actual size (2×4 = 1.5 × 3.5, 2×6 = 1.5 × 5.5, 4×4 = 3.5 × 3.5, slat = 1 × 2⅝).

A · Front elevation (open side)
120 roof (10 ft) 96 frame (8 ft) 78 front post 12 12 OPEN FRONT rear slats visible behind 2×6 rim · 2×4 slat floor (hidden by side slats) 2×6×10 front beam · 1×6 cedar fascia above
Six 4×4 posts (three visible) bolt inside the 2×6 rim with black structural screws. The 10 ft beams fasten to the outer post faces and overhang 12" each side. Rafters sit on the beams at 24" on center behind a 1×6 cedar fascia. Two 24" knee braces stiffen the open front. The rear wall's 26 vertical slats show through.
B · Side elevation (3:12 pitch, slats follow the roof)
48 frame · 13 slats at 3⅝ pitch slats 60" rear → 71" front top cut at 14° to meet the rafters 66 rear post 78 front post 11 11 slats run past the rim to 1" above the blocks FRONTREAR
Side slats run from 1" above the blocks to the rafter underside, hiding the rim and floor edge. Each is ~0.9" longer than the one behind it; the top is cut at 14° (3:12). Two 2×4 nailers between the posts take the nails. Rear posts are 12" shorter than front posts.
C · Floor framing plan (viewed from above)
◼ 4×4 post in block socket, inside rim · ▨ deck block (9) 96 · joists at 16 · 32 · 49¾ (left face) · 64 · 80 post blocks 3¼ · 48 · 92¾ from left, 3¼ in from front/rear 48 FRONT (open) — 2×6 rim, seven 2×6 joists 45" long
Matches the run-sheet table. Six post blocks are centered under the posts (3¼" in from the rim), so the rim and end joists bear on the block ledge beside each post. The middle row carries the end joists at ¾" and 95¼" and the center joist at 50½", whose left face sits at 49¾" against the mid posts. Interior joists are end-screwed through the rim. Floor slats (2×4 flat, ten, 8 ft) run left to right across the joists with ~1½" gaps, nailed with 3" ring-shank.
D · Roof framing plan (viewed from above)
120 · rafters 24" o.c. · purlins at 2, 24, 48, 70 from low edge · cedar fascia all round FRONT (high edge) 4 steel panels 36" × 96", cut to 72", one rib overlap = ~128" cover · rip the last panel to width, or let it run 8" long on one side
Two 2×6×10 beams carry six 2×4 rafters; four 2×4×10 purlins laid flat on the rafters take the panel screws. Rafters tie to beams with H2.5A hurricane ties (hidden behind the fascia). Panels run with the slope, ribs front-to-back.
Cut list

Cut list

PartStockQtyCut toNotes
Frame (pressure-treated)
Rim joists2×6×8 PT296"No cut
Joists (incl. 2 end joists)2×6×8 PT745"2 per board → 4 boards
Floor slats2×4×8 PT1096"No cut; lay flat, ~1½" gaps
Front posts4×4×8 PT378"Chamfer top edges ¼" on the table saw before install
Rear posts4×4×8 PT366"Same
Beams (front & rear)2×6×10 PT2120"No cut
Rafters2×4×8 PT672"Square cuts; 24" offcuts → braces
Knee bracesrafter offcuts224"45° both ends
Purlins2×4×10 PT4120"No cut; flat on rafters
Wall nailers (back 4, sides 4)2×4×8 PT844¼"Between posts, flat, at 20" and 40" above the rim. 2 per board → 4 boards
Skin and trim (cedar)
Slat stock5/4×6 cedar decking—rip to 2⅝"Each 5½" board yields two 2⅝" strips (⅛" kerf). Rip everything first.
Back slats5/4×6×10 cedar2659¾"4 per board (2 strips × 2 lengths) → 7 boards, 2 spare slats
Side slats, 13 per side5/4×6×12 cedar2660" → 71"Length = 60 + 0.9 × n (n = 0 rear … 12 front), top cut 14°. Pair slat n with slat 12−n on one strip (≤131") → 4 per board → 7 boards
Fascia, front & rear1×6×10 cedar2121½"Overlaps side fascia ends; front and rear fascia top edge beveled 14° optional
Fascia, sides1×6×8 cedar272"Ends cut 14° plumb to match front/rear
Roof
Roof panels29-ga ribbed steel 36"×96", black472"Cut with a metal-blade circular saw or nibbler, never an abrasive wheel (burns the coating)

Side slat lengths (inches): 60.0 · 60.9 · 61.8 · 62.7 · 63.6 · 64.5 · 65.4 · 66.3 · 67.3 · 68.2 · 69.1 · 70.0 · 70.9, rear to front. Cut all 13 for one side, then repeat. Verify the first two against the built frame before cutting the rest.

Purchase list

Purchase list

Split to match the assembly order. Phase 1 gets the shed standing, roofed, stained and usable. Phase 2 is the cedar walls. Combined ≈ $1,300 ($1,160–1,460). Items marked ✓ were bought Oct 18.

Phase 1 · Structure, fascia, roof

ItemQtyEst. eachEst. totalNotes
Lumber
2×6×8 PT, ground-contact6$9$54Rims + joists
2×6×10 PT2$12$24Beams
4×4×8 PT, ground-contact6$14$84Posts
2×4×8 PT20$5.50$11010 floor + 6 rafters + 4 nailer stock
2×4×10 PT4$7$28Purlins
1×4×8 PT2$5$10Temporary back diagonals; reuse elsewhere after phase 2
1×6×10 cedar2$18$36Front/rear fascia (goes on before the roof)
1×6×8 cedar2$15$30Side fascia
Base and roof
Concrete deck block9$10$90Or plastic Tuff Block
Paver base, 0.5 cu ft bag5$5$252" tamped pad under each block
29-ga ribbed steel panel 3'×8', black/charcoal4$35$140Fabral, Union Corrugating, Metal Sales; any "Pro-Rib"/"Classic Rib" style
Metal roofing screws #10×1½" w/ EPDM washer, black, 100-pk1$18$18Into purlins
Foam closure strips for the panel profile2 pk$10$20Top and bottom purlin; match the panel brand
Hardware and fasteners
FastenMaster TimberLOK 4" structural wood screws, black hex head24$1.50$362 per post at rim, 2 per post at beam. Built-in washer head; 5/16" hex bit, impact driver. Must be 4": 1½" board + 3½" post = 5", so longer screws poke through.
Simpson H2.5A hurricane tie, ZMAX12$1.25$15Hidden behind fascia
Simpson SD9 1½" connector screws, 100-pk (SD9112R100) ✓2$15$30For the ties: ~10 per H2.5A × 12
Deckmate #9×3" green wood decking screws, 5 lb (309) ✓1$35$35Frame corners, joists, nailers, purlins, braces, fascia corners
Paslode #657385 30° paper-tape 3"×0.120" ring-shank, hot-dip galvanized, 750 ✓1$45$45Floor slats with the DeWalt 30° framing nailer
Senco 15 ga DA 2½" galvanized finish nails (A302509), on hand1—$0Fascia only. Electro-galvanized: not for the cedar slats.
Finish
Semi-transparent exterior stain, black, 1 gal1$45$45Cabot, Behr Premium, or Sikkens; oil-based penetrating. Frame only; apply once PT passes the water-bead test.
Optional
1" galvanized welded wire mesh, 3'×50' roll + ¾" fence staples1$70($70)Contains the stack until the slats go on; stays behind them. Not in total.
Phase 1 total≈ $880Expect $790–970

Phase 2 · Cedar walls

ItemQtyEst. eachEst. totalNotes
Lumber
5/4×6×10 cedar decking7$22$154Back slats (26 × 59¾", 2 spare)
5/4×6×12 cedar decking7$26$182Side slats (26, 60"→71", cut to measured frame)
Fasteners
15 ga DA angled finish nails, 2", stainless (304/316)1,000$40$40For the Senco finish nailer; ~210 needed. Stainless only: galvanized streaks cedar.
Finish
Penetrating cedar oil, clear or natural, 1 gal1$45$45Optional; untreated cedar silvers evenly in 1–2 years
Phase 2 total≈ $420Expect $370–490; cedar is the most volatile line

Cost levers: PT 5/4×6 decking in place of cedar cuts phase 2 by ~$200 (stain it black and the whole shed goes dark); skip the cedar oil (−$45). Buy phase 2 cedar after measuring the built frame, and pick boards with the fewest knots: they get ripped in half.

Assembly

Assembly order

Two phases. Phase 1 is the PT structure and roof: usable for stacking as soon as it's done. Phase 2 is the cedar walls, done whenever it suits, cut to the built frame.

Phase 1 · Structure, fascia, roof

  1. Site. Scalp the grass 6" beyond the 8×4 footprint. Set 9 deck blocks on 2" of tamped paver base at the centers in the run-sheet table (post blocks centered on the posts, not the frame edges). Level across every row; this is the one step where fussiness pays.
  2. Floor frame. Screw the two 96" rims to the two 45" end joists (Deckmate 3", three per corner). Set on blocks; check diagonals at 107 5⁄16". Add five interior joists at 16, 32, 64, 80" o.c. plus the center joist with its left face at 49¾" (beside the mid posts). Shim low spots with composite shims.
  3. Posts. Chamfer the tops. Drop each 4×4 into its block socket inside the rim at the corners and 48" mid-points. Plumb, brace, then two 4" TimberLOK through the rim (and two through the end joist at corners).
  4. Floor slats. Nail the ten 2×4s flat across the joists with a 1½" spacer, notching around posts. Two Paslode 3" HDG ring-shank per crossing.
  5. Beams. Clamp a 2×6×10 to the outer faces of the three front posts, top flush, 12" overhang each end. Two 4" TimberLOK screws per post. Repeat at the rear.
  6. Nailers. Screw 44¼" 2×4s flat between the posts at 20" and 40" above the rim, outer face flush with the post face: two on the back (each bay), one per side at each height. These go in now, not with the slats.
  7. Rafters and purlins. Six 72" rafters on edge at 24" o.c., 11" overhang front and rear, H2.5A at each beam. Four purlins flat on top at 2", 24", 48", 70" from the low edge. Fit the two knee braces.
  8. Temporary bracing. If the shed will stand without slats for more than a few weeks, screw two 1×4 diagonals across the back posts (an X or a single long diagonal). They come off when the back slats go on.
  9. Fascia (cedar, phase 1). Side fascia first (72", 14° ends), then front and rear (121½") lapping over them. Top edge flush with purlin top. Senco 15 ga 2½" into rafter ends and purlins, two Deckmate at each corner. This must precede the roof: the panel edges rest on it.
  10. Roof. Closure strips on top and bottom purlins. Start panels at the downwind end, overlap one rib, screw through the flat next to each rib into every purlin.
  11. Stain the frame. Once the PT passes the water-bead test (often 4–8 weeks), one coat, back-brushed. With no walls on, every face is reachable. The shed can hold wood while it waits; stain around the stack or before loading.

Phase 2 · Cedar walls (any time after phase 1)

  1. Measure the built frame. Rear height from 1" above the block to the rafter underside, and the same at the front post. Recalculate the 13 side slat lengths from those two numbers (linear between them). Pull the stack 1" off the walls.
  2. Rip and cut cedar. Rip the 14 decking boards to 2⅝" strips in one session. Cut 26 back slats at 59¾" (or to measured height) and 26 side slats to the recalculated lengths, 14° top cut.
  3. Side slats. Start at the rear post with a 1" spacer, bottom edge 1" above the blocks, nailing into rim, both nailers, and the post or beam at top. Repeat at the front. Works with wood already stacked inside.
  4. Back slats. Remove temporary bracing. Same method, left to right, 1" spacer; the first and last slat cover the side slats' ends.
  5. Cedar oil (optional) once the cedar has dried a week. Stack: split faces out, ends flush, bark up on the top row.
Judgment calls

Grey areas and judgment calls

Not an engineered or permitted designSized by rule of thumb. At ~1,800 lb of 30 psf snow on 60 sq ft the 2×4 rafters and 2×6 beams spanning 48" between posts have large margins, but no one has reviewed it. Most CT towns exempt accessory structures under 100–200 sq ft from permits; setback rules still apply. Check Roxbury's zoning page before placing it near a line.
Steel roofLouder in rain and hail than polycarbonate; darker underneath. Needs a metal-cutting blade. Overhangs hold snow a little longer than polycarbonate's slick face.
Cedar and fastenersCedar's tannins react with iron. Hot-dip galvanized nails are acceptable; electro-galvanized or plain steel will streak within a season. Stainless is the certain answer at ~$40 more.
Dark stain on PTBlack raises surface temperature and can increase checking in the 4×4s. Semi-transparent, not solid, keeps it recoverable. PT must dry 4–8 weeks before it takes stain; a water-bead test tells you.
Slat lengthsThe 60–71" side slat figures assume blocks 7" tall and the posts exactly 78"/66". Phase 2 cuts them to the measured frame, which removes the compounding-error risk.
Phase 1 with no wallsRacking is carried by the two knee braces and the post screws; add the temporary back diagonals for any long gap. Until the slats go on, wind-driven rain and snow reach the stack from the sides and back. Stapling 1" welded wire mesh to the posts contains the stack and can stay behind the slats.
PricesLate-2026 Northeast big-box estimates from general knowledge, not a live quote. Cedar decking is the most volatile line and may be special-order at some stores; PT 5/4 decking is the stocked fallback.
Ground and frostDeck blocks float on the surface; frost heave can tilt the shed a little over winters. Re-shim in spring. If the site is wet or heavy clay, set the corner blocks on dug footings.
